Work Package Development
A work package is the lowest manageable unit in the WBS, where cost, duration, and responsibility can be assigned. Each work package represents a mini-project within the larger project.

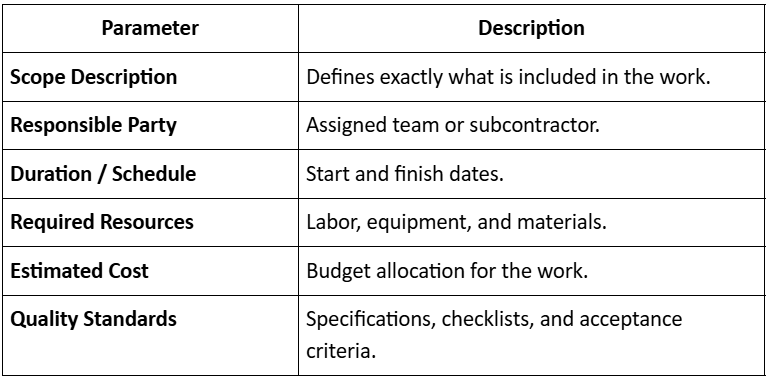

Contents of a Work Package

Steps in Work Package Development
- Identify deliverables from WBS Level 3 or 4.
- Define the work content and performance expectations.
- Estimate duration, resources, and cost.
- Assign ownership (team or vendor responsible).
- Integrate into a schedule for monitoring progress.
- Document dependencies and quality requirements.
Example:
Work Package: “Column Reinforcement – Ground Floor”
- Duration: 5 days
- Crew: 6 rebar fitters + 1 foreman
- Materials: 8 MT TMT bars
- Cost: ₹1,20,000
- Acceptance: As per IS 1786 & structural drawings
“A good work package is measurable, assignable, and trackable.”
