Performance Measurement & Earned Value Method

Earned Value Management (EVM) is the cornerstone of modern project control.

It quantifies performance by integrating scope, time, and cost into one system.

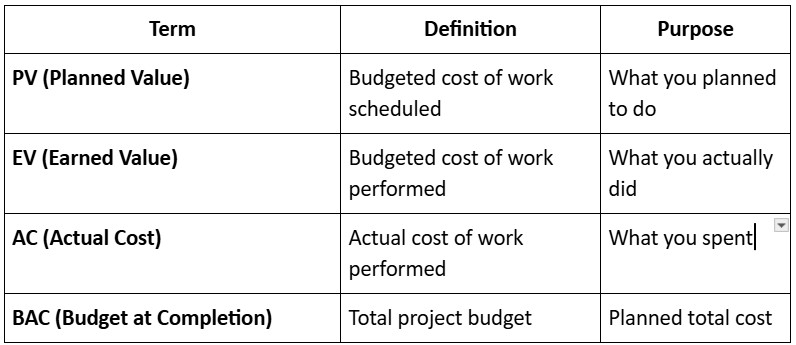

Key EVM Terms

Performance Measurement & Earned Value Method

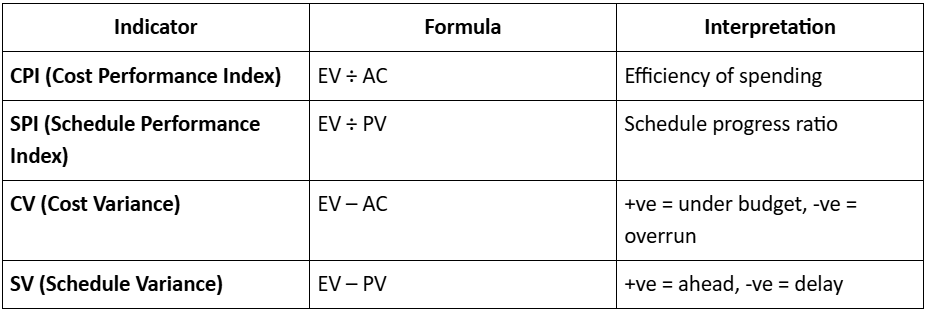

Performance Indices

Performance Indices

Example:

  • PV = ₹10,00,000
  • EV = ₹8,00,000
  • AC = ₹9,00,000

CPI = 8/9 = 0.89
SPI = 8/10 = 0.8

The project is over budget (CPI < 1) and behind schedule (SPI < 1).
