⌘K
Schedule Updates and Monitoring Techniques
Effective scheduling doesn’t end with planning — it depends on continuous monitoring and timely updates.
1. Schedule Updating
- Update progress regularly (weekly or biweekly).
- Record % completion for each activity.
- Adjust actual start/finish dates.
- Incorporate approved change orders.
Baseline vs. Current Schedule:
Compare to detect variance and evaluate project health.

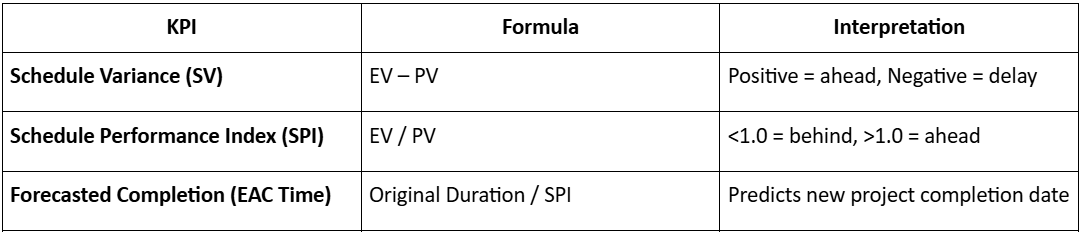

2. Key Performance Indicators (KPIs)

3. Monitoring Tools
- Gantt Charts – Visual schedule overview.
- S-Curves – Cumulative progress vs. cost/time.
- Dashboards – Real-time updates (in Orangescrum or Primavera).
- Milestone Trend Analysis (MTA) – Tracks shifting milestones over updates.
4. Corrective Actions
- Reschedule delayed tasks with float optimization.
- Apply crashing (add resources) or fast-tracking (parallel activities).
- Re-baseline only after major scope changes.
- Communicate deviations early to stakeholders.
“Updating the schedule isn’t paperwork — it’s project control.”
Module Summary
- Planning defines project scope and logic; scheduling gives it a time frame.
- CPM identifies critical activities; PERT manages uncertainty.
- Network coding ensures traceability and reporting efficiency.
- Resource and cost loading integrates manpower and money into time.
Schedule monitoring transforms static plans into dynamic control tools.
