CPM (Critical Path Method) and PERT
1. Critical Path Method (CPM)
CPM is a deterministic scheduling technique that identifies the longest path of dependent activities through the project, determining the shortest possible completion time.
Steps in CPM:
- List project activities.
- Identify dependencies (which task follows which).
- Estimate activity durations.
- Draw a network diagram.
- Compute the earliest and latest start/finish times.
- Identify the Critical Path (activities with zero float).
Key Terms:
- Float (Slack): Time by which an activity can be delayed without affecting project completion.
- Critical Path: Sequence of tasks that determines project duration.
- Crash Duration: Minimum time by increasing resources.
Example:
If the critical path is A–C–E–G = 120 days, any delay in these activities delays the project itself.
“Managing the critical path means managing the project’s heartbeat.”
2. Program Evaluation and Review Technique (PERT)
PERT is a probabilistic model used when activity durations are uncertain.
It estimates the expected time using three scenarios:
TE = (O + 4M + P) / 6
Where:
- O = Optimistic time
- M = Most likely time
- P = Pessimistic time
Example:
For an activity with O = 4, M = 6, P = 10 days:
TE = (4 + 4×6 + 10) / 6 = 6.33 days
When to Use:
- R&D or design-heavy projects.
- Early-stage planning where data is limited.
- Risk-based scheduling in EPC projects.

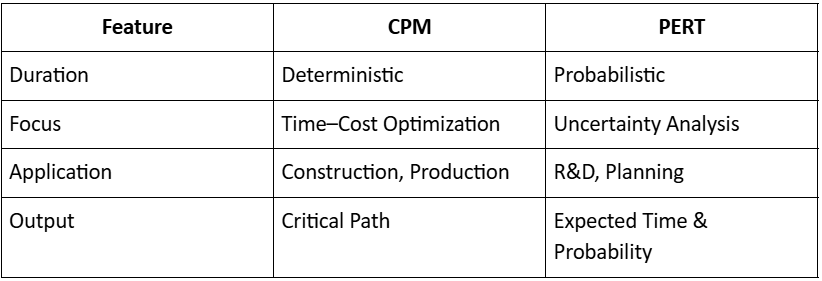

Comparison:

When to Use:
- R&D or design-heavy projects.
- Early-stage planning where data is limited.
- Risk-based scheduling in EPC projects.
Comparison:
